The original Chiswick Health Centre was outdated and no longer fit for purpose, with significant backlog maintenance estimated at £12m, which impacted service quality and staff working conditions.
The objective of this project was to replace a dilapidated 1970s health centre with a modern, fit-for-purpose facility that supports integrated care and achieves sustainability goals. The scope was to deliver a new four-storey health hub that would provide expanded clinical capacity, co-location of services, and enhanced public spaces. The hub would house a combination of GP and community health services serving over 60,000 patients.
This project was a complex multi-year endeavour to deliver, involving multiple stakeholders, including North West London ICB, West London NHS Trust, Hounslow Consortium, Chiswick Medical Practice, Chiswick Health Practice, West4 GPs and the London Borough of Hounslow. It faced significant challenges, such as maintaining service continuity during the works, legal delays, procurement complexities, and financial constraints. The initial project began in 2017, and the new facility was opened in September 2025.

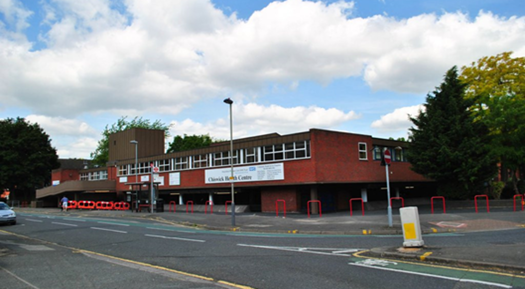

Below is a picture of the original 1970s health centre that the project looked to replace with a modern, fit-for-purpose facility that supports the community health model.
The original Chiswick Health Centre was outdated and no longer fit for purpose, with significant backlog maintenance estimated at £12m, which impacted service quality and staff working conditions.
Redevelopment required the demolition of the old centre and decanting clinical services to a temporary facility, necessitating careful planning to minimise disruption to patient care and staff operations.
The project involved multiple stakeholders, including commissioners, service providers, the local authority, and housing partners. Achieving consensus and managing expectations across public sector organisations was complex and required robust engagement strategies.
The process was complicated by government COVID-related stay on eviction regulations, resulting in an 18-month delay to the programme and loss of Estates and Technology Transformation Fund (ETTF) funding, which put additional pressure on project timelines and financial planning.
The team faced commercial challenges, including limited market interest in joint ventures, difficulties securing full planning permission, and the need to maintain flexibility in the delivery strategy.
NHS procurement processes proved challenging, with protracted negotiations with contractors threatening the loss of key funding streams, such as GLA funding for key worker homes.
The project aimed to release surplus land for 55 social rented homes with preference for NHS key workers, delivered by development partner Hounslow Council, requiring innovative structuring of joint development agreements and nomination rights to ensure delivery and long-term benefit to the NHS workforce.
The team had to manage risks related to construction delays, cost inflation, and the need for timely capital receipts to support both health centre delivery and housing provision.
Ensuring a smooth transition from the temporary decant facility back to the new centre, while structuring leaseback and disposal arrangements to meet financial year-end targets, added further complexity.
Due to the complexity of this project, several of our teams were engaged to support the delivery of the new health centre.
Learn more about our Estate Strategy team
The Development Management team worked to incorporate low-carbon technologies into the project to support the NHS’ zero carbon initiative, they included:
Through their work, the project achieved BREEAM “Excellent” rating and 77% carbon reduction.
